#1. SR-104, Hood Canal Bridge retrofit and east-half replacement

Cost:$204 million (original contract)


Courtesy of WSDOT

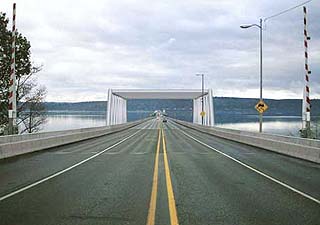

Work to replace the east portion of the Hood Canal Bridge includes creating an 8-foot shoulder along the length of the bridge.







Project address:
SR-104, Mile Post 13.9-14.7 across the Hood Canal

Start of construction:
Aug. 11, 2003

Expected
completion date:

September 2007

Owner:
Washington State Department of Transportation




Description

The state Route 104 Hood Canal Bridge retrofit and east-half replacement project will overhaul the deteriorating eastern portion of the 1.5-mile floating bridge, which is a critical connection between the Kitsap and Olympic peninsulas.

In order to replace the eastern half of the bridge, General Construction Co./Kiewit Pacific Co. are collaborating to construct 14 new floating concrete pontoons that the roadway will be built on top of.

Three additional, existing spare pontoons are being reconstructed and used in the bridge replacement. Three-inch cables will anchor the pontoons in place in water that ranges between 80 to 340 feet deep. Anchors holding the bridge in place weigh 685 to 1,875 tons each.

The Hood Canal Bridge, constructed in 1961, was the second floating bridge built in the state. It is the longest floating bridge across saltwater. The harsh saltwater environment creates special demands on the structure, requiring it to withstand tidal variations of up to 15.5 feet.

Pontoons are undergoing construction at a graving dock in Port Angeles and will be floated to the bridge location. A large, in-ground graving facility for building the pontoons and anchors was constructed. The lower floor of the graving facility reaches 60 feet deep to accommodate the enormous pontoons.

Due to the off-site construction of the pontoons, the bridge will remain open for the majority of the construction period, except for an eight-week stretch.

Funding for the bridge does not provide for expansion with additional lanes, it only allows for replacing the existing bridge. Replacing the bridge is more cost effective than trying to repair the weakened structure, taking into consideration the additional cost that would be required to increase capacity.

However, the new east half of the bridge will be wider and have 8-foot shoulders running the entire length. Wider shoulders will support bridge maintenance efforts, reduce impact from vehicle breakdowns, and provide safer travel for bicycles and pedestrians.

The western half of the bridge was rebuilt in 1982, after it sank in a severe storm. Along with the present Hood Canal retrofit and east-half replacement project, the west side of the bridge will get new approach spans and new transition truss spans.

PROJECT PARTICIPANTS

Contractor:

General Construction Co./Kiewit Pacific Co. Joint Venture, 19472 Powder Hill Place, Poulsbo, WA 98370, (360) 565-2700

Engineers:

(Original replacement design) Parsons-Brinckerhoff, 999 Third Ave., Suite 2200, Seattle, WA 98104-4001, (206) 382-5200

(Graving dock design) KPFF, 1601 Fifth Ave., Suite 1600, Seattle, WA 98101, (206) 622-5822




Other Participants
ABW Technologies
AVAR
Con-Force Structures
Concrete Technologies
DBM/Case
Elcon Corp.
Fred Hill Materials
Freeman Marine Equipment
Jesse Engineering Co.
RPM
Theriault Industries
Thompson Metal Fabricators
Universal Structural
