November 18, 2010
This list represents campus projects that are planned or under way. Cost estimates reflect the total project budget. Start and finish dates are for construction only. Budgets and time lines for future projects are projected and may be revised.
Left off the list were private developments, such planned projects for the School of Medicine’s South Lake Union campus, and on-campus projects by other agencies, such as Sound Transit’s University Link light-rail station.

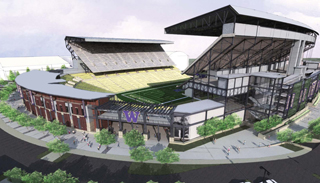

1. Husky Stadium renovation
The renovation will involve the demolition and reconstruction of the lower bowl and southside upper stands. The track will be removed, and the field lowered 4 feet. A 70,000-square-foot facility for football operations will be housed in the west end of the stadium.
Budget: $250 million
Location: Seattle
Architect: 360 Architecture
General contractor: Turner Construction Co.
Start: Late 2011
Finish: Fall 2013

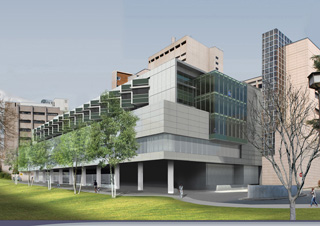

2. UW Medical Center expansion
An eight-level hospital addition will add 163,000 square feet south of the medical center’s Pacific Tower on Columbia Road. A future second-phase project will bring the total to 273,000 square feet.
Budget: $210.5 million
Location: Seattle
Architect: NBBJ
General contractor: Skanska USA
Start: March 2009
Finish: July 2012
3. Residence halls, Phase 2
Mercer Hall will be demolished and replaced by a 900- to 1,000-bed apartment project. A 200-unit apartment project planned at a second site would be completed a year later. The scope may grow to include the replacement of Lander Hall (550 beds), adding $77 million to the existing budget.
Budget: $168.5 million
Location: Seattle
Architects: Ankrom Moisan Associated Architects, Feilden Clegg Bradley Studios
General contractor: W.G. Clark Construction Co.
Start: Mercer Hall, July 2011; second site, December 2012
Finish: Mercer Hall, August 2013; second site, July 2014
4. Residence halls, Phase 1
Work is under way to build Cedar Apartments (350 beds) and Poplar Hall (270 beds). The second half of the project will see the construction of Elm Hall (430 beds) and Alder Hall (600 beds).
Budget: $161.9 million
Location: Seattle
Architect: Mahlum
General contractor (Cedar Apartments, Elm Hall): W.G. Clark Construction Co.
General contractor (Poplar Hall, Alder Hall): Walsh Construction Co.
Start: Cedar and Poplar, March 2010; Elm and Alder, January 2011
Finish: Cedar and Poplar: June 2011; Elm and Alder, July 2012
5. Husky Union Building renovation/expansion
The project will add student space and make the building more open and cohesive. New additions will bring the total space up to 300,000 square feet, up from 260,000 square feet.
Budget: $128.3 million
Location: Seattle
Architect: Perkins + Will
General contractor: Skanska USA
Start: July 2010
Finish: July 2012
6. Residence halls, Phase 3
Terry Hall will be renovated and expanded to provide 120 additional beds for a total of 720. The plan currently calls for the replacement of Lander Hall (550 beds), but that project could be grouped with second-phase work (see No. 3 on this list). A newer proposal would include the replacement of the 1101 Cafe building with 500 new student apartment units and the renovation of McMahon Hall (1,067 beds). This budget for this alternative would be $237 million.
Budget: $85 million (Terry and Lander halls only)
Location: Seattle
Architect: Mithun
General contractor: Skanska USA
Start/finish: To be determined
7. Molecular Engineering Interdisciplinary Academic Building
First phase of a 90,300-square-foot research lab project. A future phase, currently unfunded, would bring the total to 160,000 square feet.
Budget: $77.7 million
Location: Seattle
Architect: ZGF
General contractor: Hoffman Construction
Start: August 2009
Finish: August 2011
8. UW Bothell, Phase 3
This 75,000-square-foot project will provide additional academic space to support new and expanded degree programs on UW’s Bothell campus.
Budget: $68 million
Location: Bothell
Architect: THA Architecture
General contractor: Lease Crutcher Lewis
Start: July 2011
Finish: May 2013
9. UW Tacoma, Phase 3
The Russell T. Joy Building is being renovated for classrooms, offices and commercial space, and three rooms in the Science Building have been converted to lab space. The second half of the project will involve the construction of the four-story Tioga Library Building for a library expansion, classrooms, offices and other academic support areas.
Budget: $54.3 million
Location: Tacoma
Architect: THA Architecture
General contractor: Korsmo Construction
Start: Joy Building, July 2009; Tioga Library Building, December 2010
Finish: Joy Building, January 2011; Tioga Library Building, March 2012
10. Balmer Hall replacement
Second phase of the Foster School of Business complex. The 63,000-square-foot building will have student and program offices, a multipurpose/dining room and catering kitchen. Foster Library book stack space will also be in the new building.
Budget: $46.3 million
Location: Seattle
Architect: LMN
General contractor: Sellen Construction
Start: September 2010
Finish: May 2012
